How Much Does a Sauna Cost? Equipment, Installation and Operating Costs

Direct answer: Sauna cost is the sum of equipment, building interfaces, utilities, logistics, installation, compliance work and commissioning, followed by energy, cleaning, inspection, service and downtime during operation. A product-only price cannot answer an installed-project or lifecycle question.

Compare costs only after freezing destination, sauna type, finished size, glazing, heater route, electrical supply, site conditions, delivery access, commercial duty and required evidence. Use current project quotations and local rates. This page does not publish unverified HACHILL prices, market averages, freight rates, energy consumption, labor or payback claims.

CapitalSeparate product from every site and delivery interface.
OperatingMeasure startup, holding, recovery and auxiliaries.
EvidenceAttach source, date, scope and owner to every value.
ApprovalClose allowances and changes at named hold points.

Freeze the Cost Basis Before Comparing Any Number

Sauna cost basis and source register
InputRequired recordCost effectSource/owner
DestinationCountry, site, currency, tax basis and required compliance pathChanges product configuration, documents and local workBuyer/project lead
Sauna scopeType, finished dimensions, users, glazing, heater and controlsDefines equipment and room loadDesigner + supplier
Delivery formatSite-built components, kit, flat pack or assembled cabinChanges freight, access and laborBuyer + logistics
Building interfaceBase, floor, drainage, ventilation, power and weather workOften excluded from product quoteLocal designer/trades
Operating dutySessions, door openings, warm-up, occupancy and cleaningDrives energy, wear and downtime exposureOperator
Acceptance evidenceSubmittals, inspection, commissioning and handoverAdds work but reduces dispute riskProject authority

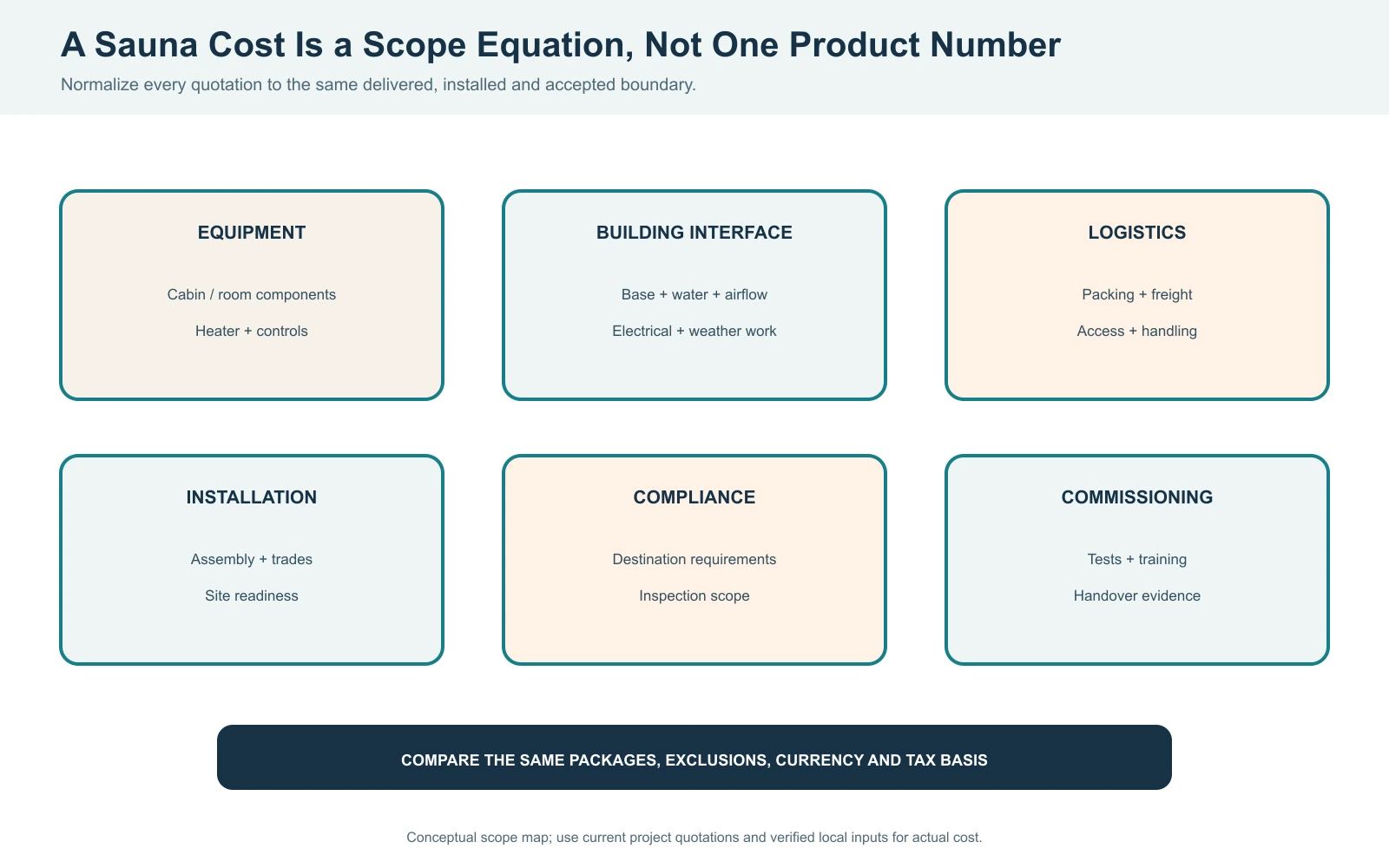

Sauna capital cost scope diagram separating equipment building interface logistics installation compliance and commissioning
A comparable sauna budget separates equipment from site, logistics, installation, compliance and commissioning packages.

A useful cost answer must declare whether it means equipment-only purchase, delivered package, installed room, or multi-year commercial ownership. Those are different questions. Record currency, tax treatment, price-validity date and exchange-rate basis where relevant. A quote without these conditions may look precise but cannot be compared reliably.

No verified HACHILL price list, freight rate, local labor rate or universal market average is supplied here. Collect those values from a current scoped quotation and qualified local providers. This article explains the calculation and evidence path so the inputs are comparable.

Separate Capital Cost Into Controllable Packages

Capital cost package and exclusion matrix
PackageTypical contentsCommon exclusionEvidence
EquipmentCabin/room components, heater, controls, benches and declared accessoriesBuilding work and local connectionsApproved bill of materials/submittal
Building interfaceBase, framing, waterproofing, drainage, weather and ventilation workUnknown existing-condition repairIssued drawings and local quote
UtilitiesElectrical supply, protection, isolation and declared connectionsService upgrades outside work areaQualified MEP scope
LogisticsPacking, freight, customs basis, site handling and protectionDemurrage, storage or abnormal liftingRoute survey and logistics quote
InstallationAssembly, glazing, heater/controls and trade coordinationRework caused by unready siteMethod and labor scope
Compliance/commissioningRequired review, inspection, tests, training and handoverUnstated authority feesAcceptance schedule

The sauna package may include the structure, lining, benches, door, lighting and controls, but inclusions vary. Record whether the heater, stones, guard, control panel, wiring accessories and ventilation components are supplied. For outdoor models, add foundation or base work, roof drainage, weather protection and site access.

Site costs are local. Licensed electrical work, mechanical ventilation, waterproofing, lifting, permits and finishing can exceed expectations when they are discovered after ordering. Obtain site-trade allowances before committing to a product whose power or access requirements are not confirmed.

Project planner reviewing wellness equipment requirements at a desk
Cost planning begins with a frozen equipment, site, logistics, installation and acceptance scope.

A low equipment number can be valid and still produce a high installed total when the site requires an electrical upgrade, structural base, waterproof transition, difficult access or weather protection. Do not call those automatically supplier overrun; first determine whether the original quote included the interface.

Normalize Supplier Quotations to the Same Scope

Use a common package list and add only documented exclusions. The following calculation uses dimensionless cost units, not dollars and not a market-price claim. It demonstrates why the lowest equipment line may not be the lowest comparable total.

Illustrative quotation normalization using cost units
Cost packageQuote AQuote BNormalization note
Equipment100 units118 unitsDeclared package basis
Freight/handling+18IncludedUse same destination and delivery term
Site interfaces+22+12Use verified local scope
Installation+15+14Same trade and completion boundary
Commissioning/evidence+5+6Same release package
Comparable total160 units150 units100+18+22+15+5; 118+0+12+14+6

Cost units preserve the arithmetic without inventing real pricing. Replace each unit with a current quote or approved estimate and retain its source. If a value is an allowance, label it separately from a firm price and state the quantity or event that will convert it.

Create one schedule listing internal dimensions, heat system, visible materials, glazing, controls, electrical supply, packaging, Incoterm, destination and installation responsibility. Ask suppliers to mark every included, optional and excluded line. This exposes whether a low price omits a heater, local connection or export packaging.

For OEM or distribution projects, add sample cost, tooling or engineering charges, spare parts, documentation, packaging artwork and inspection. Unit price alone does not describe the cost of bringing a repeatable product to market.

Illustration of a business meeting for wellness equipment planning
A quote review should reconcile inclusions, exclusions, quantities, evidence and change rules before award.

Calculate Operating Energy From Measured Duty, Not Nameplate Alone

Energy for a test period can be estimated as the sum of input power multiplied by run time in each state: E = sum(P x t x load fraction). For a hypothetical calculation only, a declared 9 kW heater operating at full input for 1.2 hours and an average 40% duty for the next 2 hours gives (9 x 1.2) + (9 x 0.40 x 2) = 18.0 kWh. This is arithmetic, not a HACHILL model result or typical consumption claim.

Sauna startup, holding and recovery energy record
StateInput to collectCalculationBoundary
Cold startVerified input and elapsed run stateP x full/partial run timeAmbient and room must be recorded
HoldingCycling or metered intervalMetered kWh or P x duty fraction x timeDo not assume full nameplate continuously
Door/user recoveryEvents, occupancy and recovery intervalIncremental measured energyCommercial schedule specific
AuxiliariesFans, controls, lights or pumps where presentSeparate meter/input recordConfiguration specific
CostMeasured kWh and local tariff structurekWh x applicable tariffDemand, tax and time-of-use may differ

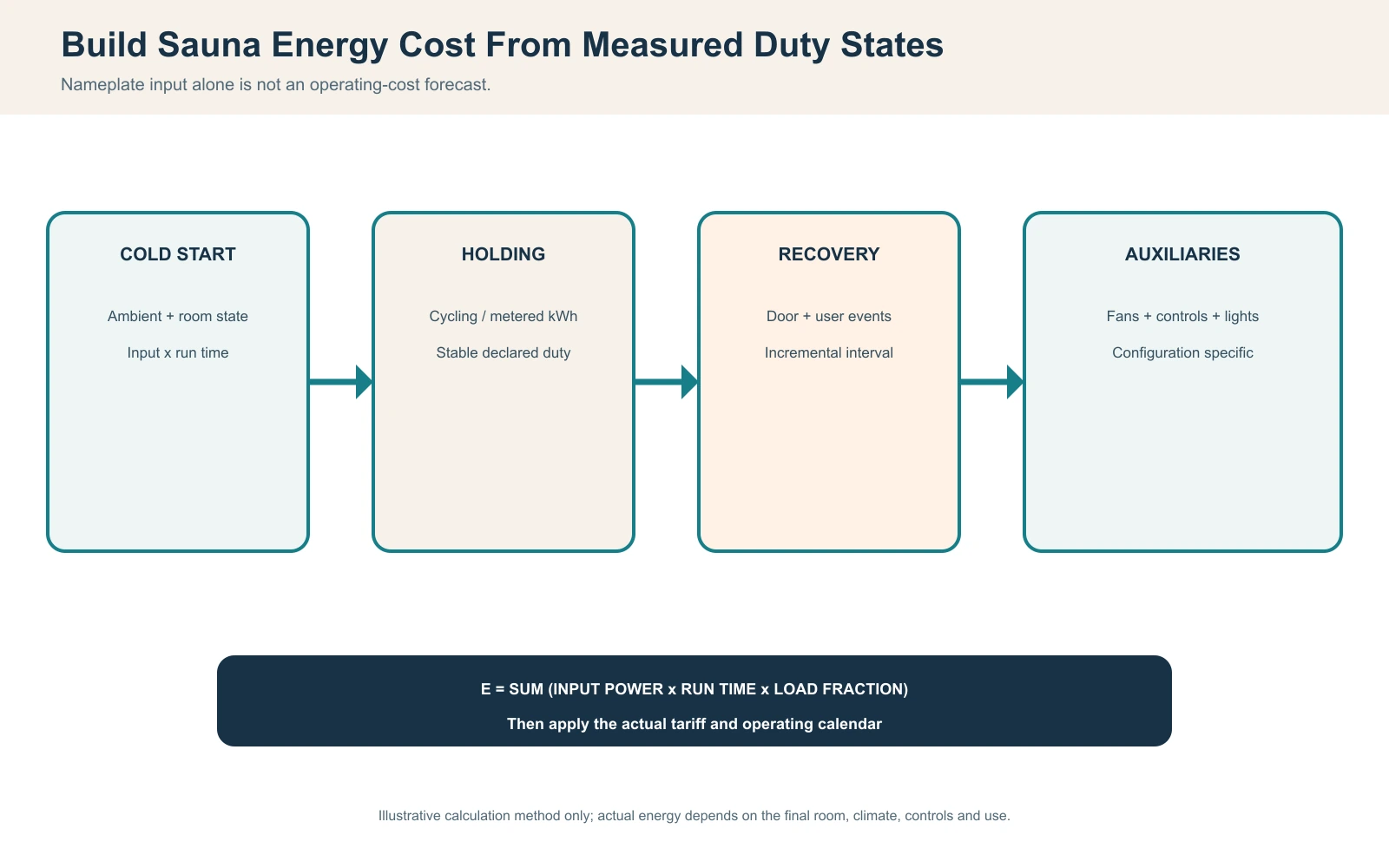

Sauna operating energy diagram separating cold start stable holding door recovery and auxiliary loads
Measure startup, holding, occupied recovery and auxiliary loads separately before annualizing operating cost.

A heater's rated input is the maximum electrical demand while energized; it is not necessarily the average consumption across a complete session. Estimate energy as rated input multiplied by warm-up plus cycling time, then multiply by local tariff. Use supplier data or a monitored trial for a more reliable duty factor.

Insulation, glazing, room volume, starting temperature, ventilation and door openings affect run time. A commercial sauna with repeated entry has a different energy profile from a residential cabin used twice per week. State those assumptions whenever a monthly figure is presented.

Annualizing one test requires an operating calendar: sessions per day, operating days, seasonal ambient conditions, preheat policy, door schedule and downtime. A nameplate-only estimate often overstates holding energy yet may understate heavy commercial recovery. Meter the final room under declared duty where the decision justifies it.

Test the Assumptions Most Likely to Move the Budget

Budget sensitivity and data-improvement register
VariableBase evidenceSensitivity testAction if material
Glazing/effective loadIssued elevation and heater methodApproved design revisionRecheck heater, supply and warm-up
Electrical capacitySite survey and load recordUpgrade/no-upgrade scenariosObtain qualified quote early
Delivery accessMeasured route and package dimensionsManual handling vs lift planFreeze logistics method
LaborDefined tasks and local ratesNormal vs restricted accessClarify exclusions/productivity
Energy tariffCurrent tariff and billing structureSeason/time-of-use casesUse operator finance basis
DowntimeCriticality and service planPlanned vs extended outageStock parts or support path

Sensitivity analysis is not a reason to add arbitrary contingency percentages. Identify the variable, establish a base source, test a reasonable project-specific alternative and record who owns the mitigation. Unknown site conditions should remain visible allowances until investigation closes them.

Build Lifecycle Cost From Service Events and Operating Records

Sauna lifecycle service and operating cost register
Cost driverQuantity/event basisEvidencePlanning response
CleaningArea, frequency and labor methodOperator procedureDesign for access and drying
InspectionScheduled safety/build checksMaintenance planAssign qualified roles
Wear/replacement partsModel-specific list and intervals when verifiedManual/service dataAvoid invented lifetimes
Timber/surface careExposure, cleaning and finish methodCondition inspectionsUse compatible products
EnergyMetered or calculated duty x tariffTest log and bill basisUpdate after use changes
DowntimeLost availability and response pathFacility recordDefine spares/support priority

Heating elements, stones, controls, lights, door hardware and high-use timber surfaces are service items. The replacement interval depends on duty, water quality, cleaning practice and component design, so fixed lifetime claims are unreliable. Ask for part identification, access method and lead time.

A design that costs slightly more but allows heater, sensor and lighting service without dismantling the cabin can reduce future downtime. Commercial buyers should include planned inspection and temporary closure in lifecycle planning.

Nameplate power is useful for electrical design but does not by itself predict monthly energy cost. Operating hours, warm-up, standby policy, heat loss and local tariff determine the bill.

Calculate energy from measured run time

For an existing or sample installation, use a suitable energy meter and record representative warm-up and operating periods. For a proposed project, state heater input, expected sessions, warm-up policy, door-opening pattern and climate assumptions. Do not publish an exact annual saving unless both alternatives were measured or modeled under the same documented conditions.

Include cleaning, inspection and replaceable parts

Commercial operating cost includes staff time, approved cleaners, heater-stone inspection, ventilation service, door and hardware adjustment, controller support and planned replacement access. A design that requires extensive dismantling for a routine component increases downtime. Ask suppliers to identify service tasks and parts availability without assuming a fixed lifetime or warranty not present in the quotation.

Evaluate downtime as a project risk

A residential owner may tolerate a delayed repair; a hotel or recovery facility may lose bookable capacity. Document which faults can be diagnosed remotely, which spares are practical to hold and who is responsible for local electrical or building work. This does not create a guarantee, but it makes support scope comparable across bids.

Lifecycle comparison is valid only when the alternatives use the same analysis period, operating calendar, tariff basis, maintenance scope and residual assumptions. Do not claim payback from unverified energy savings or service life. Present uncertain inputs as a range or scenario and keep the source next to the value.

Price Freight, Access, Receiving and Serviceability Early

A useful cost estimate is a scope model, not a market-wide price claim. Each package should state who supplies it, what assumption drives it and which evidence will close the allowance.

Separate the cabin package from the building interface

The sauna quotation may include timber walls, benches, heater and controls while excluding the structural base, waterproof floor, ventilation ductwork, feeder cable, protective devices, fire stopping, permits and final installation. List each interface explicitly. A lower product price can become the higher installed cost when local trades must redesign missing details or reopen finished work.

Price access, freight and on-site handling early

An assembled cabin may reduce site labor but require a larger delivery path, lifting plan and protected storage. A flat-pack package shifts more labor and quality control to the installer. Compare Incoterms, packaging dimensions, unloading responsibility, final room access and damage-inspection procedures on the same basis. Freight without destination handling is not a complete delivered cost.

Use allowances only where the input is genuinely unknown

Glazing, finish grade, heater system, voltage, ventilation controls and commercial-duty requirements should be frozen before final quotation. Keep provisional sums for unresolved civil or utility work, but identify the closing document and decision date. Otherwise an allowance becomes an untraceable source of change orders rather than a controlled budget item.

Business team discussing a wellness equipment project
Project cost review should include delivery route, lifting, site readiness, service access and replacement paths.

Measure doors, corridors, stairs, turning space, roof access and lifting zones against the packed delivery format. Confirm who unloads, stores, protects and moves the package. If a completed cabin cannot reach the room, the redesign cost is a logistics-interface failure, not a heater-price issue.

Service access affects future cost. Controls, sensors, heaters, lighting, ventilation components and removable panels need an approved access path. A lower purchase price can be offset by destructive access or long downtime, but the decision must use actual service requirements rather than a generic premium claim.

Grade Cost Evidence Before It Enters the Approval Total

Evidence grades for sauna cost decisions
GradeEvidenceAllowed useBoundary
ACurrent firm quotation or contract with defined scopeApproved commitmentValidity and change terms apply
BQualified local trade/logistics quote from issued informationProject budget inputSite conditions must match
CMeasured commissioning, meter or maintenance recordOperating/lifecycle forecastRecorded duty only
DDocumented allowance with quantity and sourceVisible uncertaintyNot a firm price
EOnline average, recollection or marketing claimEarly question onlyDo not approve as project evidence

Every cost line should carry source, date, currency, tax basis, scope revision, status and owner. Evidence grade does not mean a supplier quote is infallible; it means the assumptions and contractual boundary are visible enough to reconcile later.

Assign Cost Responsibility at Each Project Interface

Responsibility matrix for sauna cost and change control
DecisionSupplierDesigner/tradesBuyer/operator
Equipment scopeDefine supplied items, options and exclusionsVerify interfacesApprove configuration
Site/building workState product needsSurvey, design and price local workProvide access/site data
LogisticsProvide packing/delivery data and termPlan local handling where assignedConfirm route and consignee duties
ComplianceProvide available model evidence accuratelyDefine local project/installation requirementsState destination and requested evidence
CommissioningProvide product procedures/support scopePerform qualified testsProvide duty and release criteria
Operating costProvide verified input dataValidate installed configurationMeter, tariff and schedule owner

Responsibility follows information and control. The supplier cannot price an unseen service upgrade; the local contractor cannot certify an unspecified product; the operator cannot attribute changed energy cost to equipment without preserving duty and tariff data. Name owners before award.

Approve the Budget With Hold Points and Change Rules

Commercial buyers need a price that can survive technical review, procurement and handover. The quotation should link each allowance to a drawing, data sheet or named project responsibility.

Freeze the destination-market specification

Confirm installation country, voltage, frequency, phase, required equipment documentation, control language, accessibility needs and commercial use pattern before final price approval. Certification language must distinguish an available option, a design prepared for assessment and a specific listed or certified model. Request current evidence for the offered configuration rather than relying on a logo in a generic brochure.

Set inspection and change-control rules

Define drawing revision, approved materials and component substitutions before production. State which dimensions, finish samples, heater/control data, labels, manuals, packaging and functional checks require buyer approval. An undocumented component replacement can affect electrical data, service parts and local compliance even when the external cabin appearance is unchanged.

Close the budget at receiving and commissioning

Use the packing list to inspect quantity, crate condition, glass and timber surfaces, labels and accessories before assembly. Hold final acceptance until utilities, controls, heater protection, temperature distribution, ventilation, door and documentation are checked. Record open items and responsible parties; a delivered crate is not the same as a commissioned commercial sauna.

Recommended hold points are: basis freeze, approved submittal, site-readiness survey, logistics release, pre-installation change cutoff, receiving inspection, commissioning and final account reconciliation. At each point, list open allowances, required evidence and the person authorized to proceed.

A change request should state the original requirement, proposed change, reason, technical impact, cost/time effect, evidence and approval. Verbal substitutions or late destination changes can affect plug, voltage, documentation, labeling, protection and installation scope; they must not be hidden inside a single total.

Reconcile Cost Disputes Against the Original Scope and Measured Quantity

Sauna cost dispute and reconciliation record
DisputePreserveRecalculateClosure evidence
Freight/handling overrunDelivery term, package data, route and event logAgreed logistics boundaryCarrier/site reconciliation
Electrical upgradeOriginal site data and equipment supply requirementIssued upgrade scopeQualified quote and approval
Energy varianceMeter data, ambient, duty, tariff and configurationSame-period/same-duty basisControlled measurement review
Installation laborTask scope, site readiness and change logMeasured variationApproved time/quantity record
Damage/replacementPacking and receiving photosTransit vs site responsibilityAgreed disposition
Missing evidenceSubmittal and contract requirementsOutstanding deliverable value/statusDocumented acceptance or correction

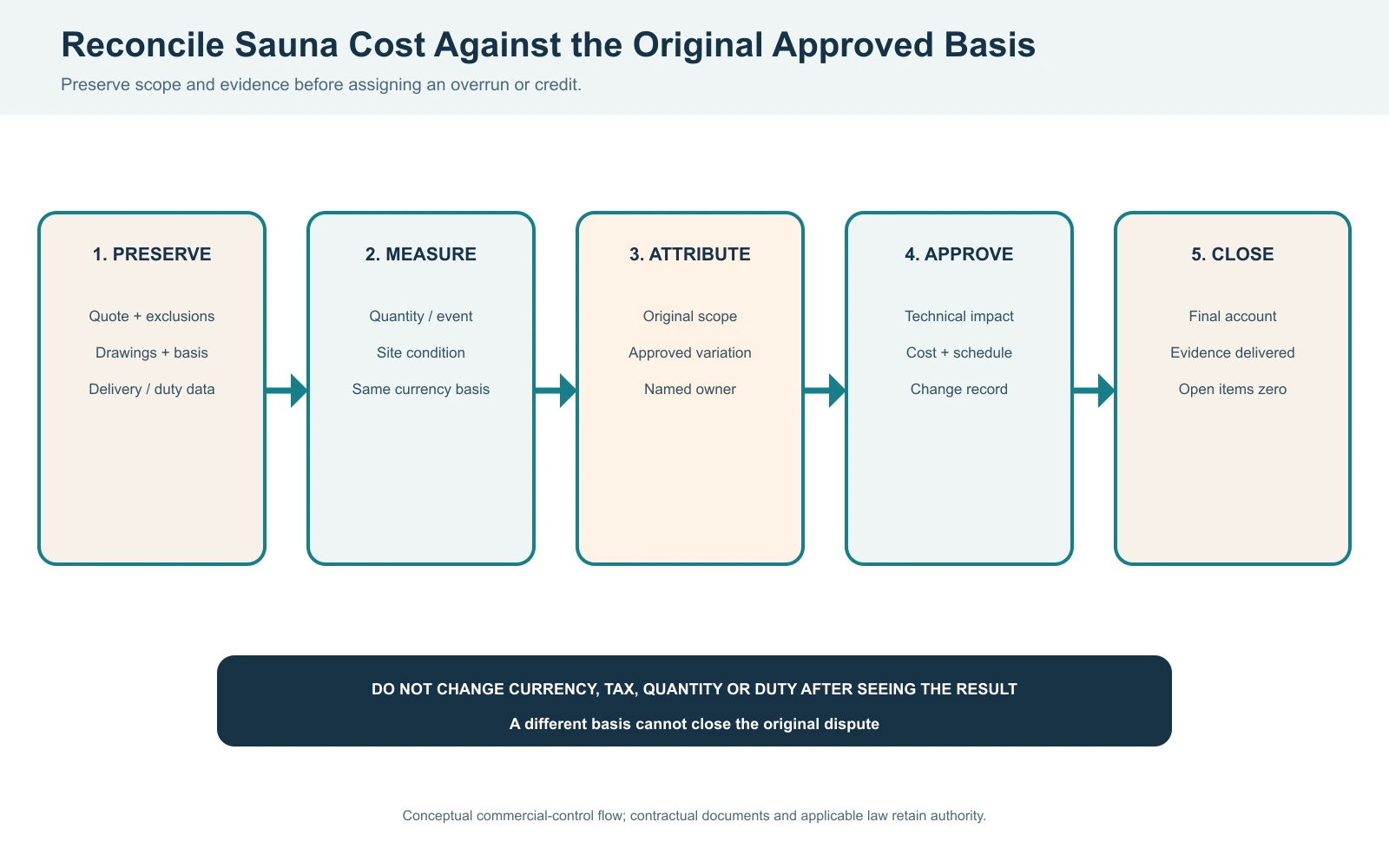

Sauna cost dispute reconciliation flow preserving original scope measuring variation approving change and closing the final account
Cost disputes close against the original scope, measured variation, approved change and documented final-account basis.

Do not change the cost basis after seeing an unfavorable result. Preserve the original quote, exclusions, drawings, operating assumptions, receiving evidence and change approvals. Recalculate on the same currency, tax, quantity and duty basis unless a formally approved change replaces it.

Engineering example

Destination requirements change after order review

Problem: Plug, supply, labeling or documentation must change late.

Likely cause: Destination and compliance scope were not frozen before selection.

How to check: Compare the original basis, approved submittal and new authority or buyer requirement.

Prevention/correction: Issue a controlled change showing technical, cost and schedule impact; do not describe optional preparation as completed certification.

Frequently Asked Questions

What is included in the cost of a sauna?

It depends on the quote boundary. Separate equipment, building interfaces, utilities, logistics, installation, compliance work and commissioning. Record taxes, delivery terms, exclusions and local work so quotations use the same installed scope.

How can I estimate sauna electricity cost?

Measure or model startup, holding, recovery and auxiliary energy separately. Multiply verified kWh by the applicable local tariff, including time-of-use or demand elements where relevant. Record ambient conditions, room configuration and operating schedule before annualizing.

Is a prefab sauna cheaper than a site-built sauna?

Not universally. Prefab can reduce some site variability, while site-built can fit architecture and local trades. Compare delivered and installed scope, access, utilities, weather interfaces, evidence, service access and lifecycle assumptions on the same basis.

Why is the equipment quote lower than the installed sauna budget?

Product quotes often exclude base work, waterproofing, drainage, ventilation, electrical upgrades, access/lifting, local permits, installation and commissioning. These are real project interfaces, not necessarily supplier price changes.

What should I send for a comparable sauna quotation?

Provide destination, currency/tax basis, sauna type, finished dimensions, users, glazing, heater route, utilities, site/access details, delivery format, commercial duty, required evidence, quantity and timeline. Mark any unknown input as an allowance to close later.

Reference Basis and RFQ Data

Sauna cost RFQ data sheet

  • Destination, currency, tax and delivery-term basis
  • Sauna type, finished dimensions, glazing and users
  • Heater route, voltage, frequency and phase
  • Indoor/outdoor site, climate, base, drainage and ventilation
  • Delivery access, lifting, storage and installation responsibility
  • Commercial schedule, cleaning and commissioning duty
  • Required product evidence, manuals, drawings and inspection
  • Quantity, branding, packaging and project timeline where applicable

Build a Comparable Sauna Cost Brief

Send HACHILL the destination, room/cabin scope, dimensions, glazing, heater route, utilities, delivery/access conditions, use schedule, evidence requirements and quantity. A scoped response is more useful than an unsupported market average.

Request a Scoped Sauna Quotation
